Aseptic Filling

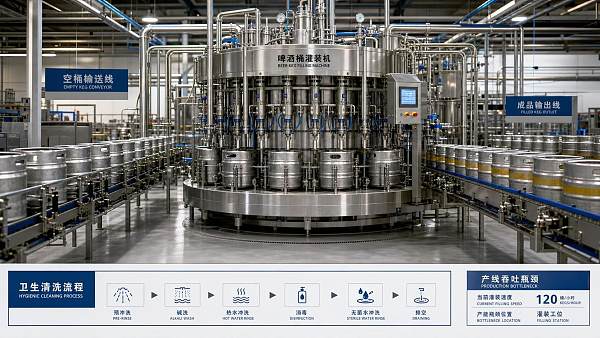

When a Keg Filling Machine Becomes a Throughput Bottleneck

Posted by:
Publication Date:Aug 05, 2026
Views:
Share

A beverage line can miss its output target even when the filler itself is not technically “down.” In many plants, the real problem starts when the keg station cannot keep pace with upstream brewing, blending, or bright tank release schedules. The machine still runs, but it runs too slowly for the production plan, requires too many interventions, or forces operators to queue cleaned kegs and finished product. At that point, the filling area stops being a simple packaging step and becomes the line constraint.

For project managers and engineering leads, that distinction matters. A throughput bottleneck at the keg filler affects tank utilization, labor planning, sanitation windows, dispatch timing, and product freshness management. It also tends to be misdiagnosed. Teams often blame “insufficient speed” when the root cause is actually changeover losses, poor keg presentation, unstable utilities, excessive foam, or cleaning routines that were never matched to the intended run profile.

Why the bottleneck often appears later than expected

Keg operations usually look adequate during early commissioning. Demand is still ramping up, SKUs are limited, and maintenance crews are highly attentive. The equipment may meet its nominal cycle target under controlled conditions, yet struggle once real production variability enters the picture.

That is when project teams discover that nameplate capacity and usable capacity are not the same thing. A filler that performs acceptably on long runs with a single keg format may become restrictive when the plant adds more package sizes, tighter hygiene controls, or shorter campaigns. If the machine was selected around theoretical hourly output without enough attention to cleaning time, gas management, valve reliability, and operator handling, the bottleneck tends to surface only after the rest of the facility has already scaled.

The issue is more pronounced in beverage plants where kegging is not the dominant package type but still serves important channels such as hospitality, export, contract fills, or seasonal product launches. In that setting, management may underestimate how much disruption a slow keg line can cause because the majority of volume still leaves in bottles or cans. Yet any package format tied to committed deliveries can become a critical path.

What a real throughput bottleneck looks like on the floor

Throughput problems are not limited to a simple count of kegs per hour. On the floor, they show up as a pattern:

  • Bright beer or finished beverage waits too long for packaging release.
  • Operators pause production repeatedly to correct coupler engagement, purge cycles, or fill level instability.
  • Cleaning and sanitation consume a disproportionate share of shift time.
  • Quality checks find oxygen pickup, inconsistent carbonation retention, or foam-related underfills.
  • Empty keg handling and filled keg removal interfere with the machine’s productive time.
  • Maintenance work happens in short reactive bursts instead of planned interventions.

When several of these conditions appear together, the filler is not just a machine with limited speed. It is the center of a process mismatch between hygiene requirements, packaging demand, and line support systems.

Hygiene losses can reduce output more than mechanical speed limits

The supplementary topic of hygiene and output checks is where many plants find the most useful answers. Keg filling is unusually sensitive to cleaning discipline because the package returns from the field. Even when incoming kegs have passed external inspection, the filler must still manage internal sanitation, purge effectiveness, valve cleanliness, and the risk of cross-contamination between products or batches.

Project teams sometimes focus on the machine cycle while overlooking sanitation dwell time, rinse verification, and recovery from failed hygiene checks. In practice, hygiene control can define true output. If a plant shortens cleaning steps to chase volume, it may create microbiological risk, flavor carryover, or unstable shelf performance. If it overextends every sanitation sequence, it sacrifices capacity and labor efficiency. The right balance depends on product sensitivity, return-keg condition, and the plant’s quality release standards.

A useful review starts with time accounting. How much of the scheduled shift is spent on filling, on internal cleaning, on waiting for chemical preparation, on operator checks, and on rework after suspect kegs? Once that split is visible, managers can decide whether the remedy is higher-capacity equipment, a better keg acceptance process, utility improvements, or procedural changes.

When a Keg Filling Machine Becomes a Throughput Bottleneck

Where engineering teams should check before replacing equipment

Replacing a machine is expensive, disruptive, and often unnecessary if the real constraint sits elsewhere. A structured check usually includes the following areas.

1. Keg condition and incoming variation

A keg line rarely behaves consistently if the incoming keg population is inconsistent. Damaged spears, worn seals, residual pressure variation, poor prior washing, and mixed formats all extend handling time and increase reject events. A plant that accepts wide variation without an effective pre-screening routine will see the filler absorb problems that should have been filtered out earlier.

If project managers are reviewing line expansion, they should ask whether the filler was specified for the keg condition actually seen in operation, not the cleaner ideal assumed during procurement.

2. Gas, pressure, and foam control

Beverage filling speed depends on stable product and gas conditions. Carbonated products are especially vulnerable to temperature drift, pressure inconsistency, and poor purge control. Foam generation slows the cycle, increases cleanup time, and can compromise fill accuracy. In many applications, what looks like a machine throughput issue is partly a utility-control problem.

Checks should include gas supply stability, regulator response, product temperature before filling, and whether line layouts create unnecessary pressure losses. It is difficult to sustain output when the machine is forced to compensate for unstable process conditions.

3. Cleaning sequence design

Not every sanitation delay is excessive by definition. The question is whether the sequence matches the contamination risk and production pattern. If every short stop triggers an overly conservative cleaning loop, availability falls quickly. If the cleaning logic is too narrow for the return-keg condition, the plant may lose even more time to investigation and rework.

Engineering reviews should compare actual stop categories with cleaning triggers. Some interruptions justify a complete cycle; others may only need a shorter verified routine. The answer is process-specific, but the classification matters.

4. Mechanical handling around the filler

Keg filling stations often become isolated islands with limited infeed and discharge buffering. Operators then spend time moving containers, resolving jams, and managing staging areas rather than keeping the equipment in a productive state. A machine with acceptable fill speed can still limit the line if surrounding conveyance, lift tables, inspection points, or pallet transfer are undersized.

Throughput should be reviewed as a cell, not just as a single machine.

When machine selection really is the issue

Sometimes the equipment itself is the limiting factor. This usually becomes clear when utilities are stable, operators are trained, incoming kegs are reasonably controlled, and the filler still cannot maintain the required cycle with acceptable hygiene performance.

At that stage, project teams should examine whether the installed configuration matches current production needs. The relevant questions are practical: number of heads, filling principle, purge and pressurization control, ease of cleaning, valve accessibility, spare parts standardization, and how quickly operators can recover from minor faults. In some mixed-format plants, teams also compare the keg station with adjacent filling assets to understand whether packaging flexibility has become too fragmented.

That is why some managers broaden the review beyond a dedicated keg filling machine and look at parallel filling architectures used elsewhere in the plant, including multi-head bottle systems, to benchmark hygiene access, operator workload, and output per square meter. The goal is not to treat different package formats as interchangeable, but to understand how machine layout and automation level influence practical capacity.

Signs that procurement specifications were too narrow

Many bottlenecks can be traced back to an incomplete user requirement specification. Procurement documents often define target hourly output and basic product type, but miss conditions that strongly affect real-life performance.

Warning signs include:

  • No clear statement of expected run lengths and changeover frequency.
  • No acceptance criteria for hygiene verification or cleaning duration.
  • Little detail on keg return quality and format variation.
  • Limited requirements for utility stability or integration with plant controls.
  • No explicit downtime classification for factory or site acceptance testing.
  • Insufficient spare parts and maintenance access review.

For project managers, this matters because a machine can technically meet procurement language while failing operational expectations. If throughput is central to the business case, the purchase specification has to describe the production context in which that throughput must be achieved.

A practical framework for output and hygiene checks

When a line starts to constrain production, teams need a common review method that combines output with sanitation performance. Treating those as separate topics usually hides the trade-off.

Check areaWhat to reviewWhy it affects throughput
Shift availabilityScheduled time versus productive fill timeShows whether losses come from speed or downtime
Hygiene cycle timeRinse, wash, sanitize, verification, restart stepsDefines usable capacity, especially on short runs
Keg rejectsSeal issues, spear defects, contamination suspicionReject handling interrupts flow and consumes labor
Foam and fill stabilityProduct temperature, pressure balance, venting controlDirectly limits cycle consistency and net output
Operator interventionsManual resets, coupler checks, handling correctionsHigh intervention rates reduce repeatable capacity
Line integrationInfeed, discharge, buffering, pallet flowThe filler may wait even when mechanically ready

This type of review helps separate three different problems: a machine that is too small, a process that is poorly stabilized, and a hygiene regime that is mismatched to the operating pattern.

How the bottleneck changes project economics

Once a keg station becomes the pacing step, the cost is rarely limited to missed hourly output. Tanks may be tied up longer than planned. Labor becomes less predictable because crews stay near the line for recovery and quality checks. Maintenance windows shrink because the machine is always needed, yet reliability worsens because small faults are deferred. Dispatch planning becomes more fragile, especially for products packed to order.

For engineering leaders, that means capex decisions should not be made on filler speed alone. A faster machine that is difficult to clean or sensitive to keg variation may fail to improve net plant performance. A more balanced design with easier sanitation access, clearer fault diagnostics, and better integration into upstream and downstream handling may deliver more usable throughput even if its advertised cycle is not dramatically higher.

What to ask before approving an upgrade or replacement

Before committing to a new asset or a major retrofit, it helps to ask a narrower set of operational questions:

  • Is the current loss mainly caused by hygiene routines, unstable process conditions, or actual fill-cycle limitations?
  • Does the line need peak speed, or does it need better repeatability over mixed production schedules?
  • How much incoming keg variation should the system tolerate without major intervention?
  • Can adjacent handling equipment support any increase in filler capacity?
  • What acceptance test would prove success under realistic conditions rather than ideal ones?

A keg line becomes a bottleneck when practical throughput falls below what the plant schedule requires, not simply when a brochure speed looks modest. The most effective response starts with output and hygiene checks together, because the constraint usually lives in their interaction. For project managers, that approach leads to better specifications, more realistic acceptance criteria, and fewer surprises after the rest of the plant has already moved on.
